Mulund Metro Parapet Collapse Highlights Line 4 Safety Gaps

  • Thread Author

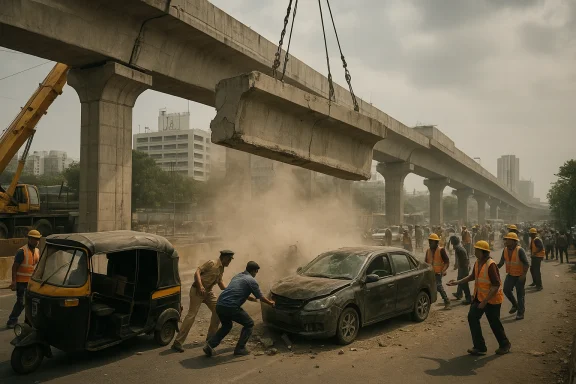

A heavy prefabricated slab from an under‑construction span of Mumbai Metro Line 4 collapsed onto LBS Road in Mulund on Saturday around midday, crushing an autorickshaw, killing one person and leaving several others injured — an accident that exposes both the engineering complexity of Mumbai’s rapidly expanding metro network and troubling gaps in on‑site safety practices.

Construction crew guides a suspended concrete beam beneath an elevated highway, creating dust and halted traffic.Background / Overview​

Mumbai’s Metro Line 4 (Wadala – Kasarvadavali) is one of the city’s largest elevated corridors, designed as a 32.3 km green‑line connector with dozens of elevated piers, precast girders and parapet elements running over some of the busiest arterial roads. The project is being delivered under the Mumbai Metropolitan Region Development Authority (MMRDA), which has in recent months reported high percentages of civil completion while pushing for phased openings.
On February 14, 2026, at approximately 12:15–12:20 PM local time, a portion of a parapet segment — described by officials as a prefabricated cement slab — gave way near pier P196 on the Rajiv (Milan) stretch close to the Mulund Fire Station and the Johnson & Johnson facility. The falling slab struck an autorickshaw and a private car on the busy LBS Road, killing one person and injuring three to four others, who were rushed to nearby hospitals. Rescue teams from the Mumbai Fire Brigade, local police, BMC ward staff and the Metro project team responded to the scene.

What happened: sequence of events and immediate response​

Eyewitnesses and preliminary reports describe the event as sudden: a prefabricated parapet section apparently detached and fell from height onto moving vehicles below. Videos circulating on social media (verified by multiple outlets) show dust, panicked bystanders and heavy concrete debris enveloping the autorickshaw and affecting adjacent traffic. Emergency crews used cutting tools and lifting equipment to extricate victims and clear the carriageway.
The MMRDA issued an on‑site statement indicating the collapse occurred near Pier P196 and that its project team was leading relief and site‑securing operations in coordination with the Brihanmumbai Municipal Corporation (BMC) and disaster management authorities. Local political leaders, including Mumbai Mayor Ritu Tawde, described the incident as “huge negligence” and questioned whether safety norms were observed during the installation of the parapet body, which some reports say had been fitted only a day earlier.
Key immediate facts corroborated across independent outlets:
  • Time and place: ~12:15–12:20 PM, LBS Road, opposite the Johnson & Johnson factory in Mulund (West).
  • What fell: a parapet/trackside slab from an under‑construction elevated metro pier (described as a cement slab or parapet segment).
  • Casualties: one person dead on arrival, three to four injured and admitted to hospital; names of deceased and injured have been reported by local outlets and confirmed by hospital/official sources.

Technical context: how elevated metro piers are built and why parapet/segment failures matter​

Elevated metro viaducts are complex assemblies of piers, precast U‑ or I‑girders, deck segments and parapet or barrier elements. To accelerate delivery in congested urban corridors, large elements are often precast offsite and lifted into position; parapet sections and service closures are sometimes cast in situ or assembled from precast units. The Line 4 project specifically has used U‑girders and heavy steel spans in places, and MMRDA documentation and recent reporting describe substantial precast and overnight installation activity to minimize traffic disruption.
A parapet or beam‑like slab that separates the deck from the edge is not merely cosmetic — it can be an integral element providing lateral support during construction, a working platform for formwork and a barrier for public safety. A failure of a parapet segment can therefore be the result of:
  • defective anchorage or temporary supports during installation;
  • inadequately cured concrete or poor bond with reinforcement;
  • failure of formwork, clamps, or lifting gear;
  • human error during hoisting and setting operations; or
  • design/quality deviations in precast fabrication.
For precast and heavy‑lift operations, well‑tested temporary works and redundant supports are essential because the load paths during handling differ from the finished structure. When temporary supports are removed or altered prematurely — or when traffic continues beneath an active heavy‑lift zone — the risk to street users is acute. Independent engineering analyses after comparable incidents consistently single out temporary works, sequencing errors and inadequate site exclusion as root causes.

Official statements, local leaders and the MMRDA response​

The MMRDA’s early statement confirmed the collapse near Pier P196 and said the authority’s project team was coordinating relief efforts with BMC and disaster management. Several outlets quoted the authority as saying two individuals were initially reported injured and were taken to hospital; other reports — reflecting hospital briefings and later confirmations — identified a fatality and up to four people admitted with varying injuries. This variation is common in fast‑moving incidents as casualty figures evolve.
Mayor Ritu Tawde’s on‑scene comments — calling the mishap “huge negligence” and noting the parapet had been fitted only the previous day — have amplified public outrage and placed political pressure on the MMRDA and the contractor to explain site procedures and who authorized work over live traffic. The mayor asked whether traffic should have been stopped during the activity, a point that strikes at the heart of work‑zone safety in urban construction.
State political leaders and the chief minister’s office reacted as well: according to multiple reports, the Maharashtra state leadership expressed grief and indicated compensation would be considered for the deceased; MMRDA announced a technical inquiry to ascertain sequence and cause. These are standard steps, but the true test will be the thoroughness and independence of the investigation.

Names, injuries and human impact​

Several outlets reporting from hospital sources and official briefings have named the deceased and injured: the person reported dead was identified in local reports as Ramdhan Yadav, and those admitted included Rajkumar Indrajeet Yadav (45, critical), Mahendra Pratap Yadav (52) and Deepa Ruhiya (40), with varying conditions noted by treating physicians. Whether all media lists will remain identical as investigations proceed, these on‑the‑ground patient disclosures provide early human detail to an otherwise technical story. Journalists and editors must treat victim identities with care while confirming next of kin notifications and official hospital records.

Safety practices, legal standards and likely areas investigators will probe​

Metro construction in India is governed by a mixture of contractual specifications, Indian national standards (BIS), guidelines such as the Indian Road Congress (IRC) for roadway interactions, and project‑level safety management systems mandated by the client (MMRDA) and enforced through the contractor’s safety officer. Key areas for any inquiry into this collapse should include:
  • Temporary works design and verification: Were hoisting anchors, staging and formwork designed by qualified engineers and checked by an independent temporary‑works engineer?
  • Lifting and handling procedures: Was the parapet precast and lifted intact? Were certified cranes and slings used with correct load charts and tag lines?
  • Quality control and material compliance: Were concrete mixes, reinforcement placement and curing certificates in place and traceable?
  • Traffic exclusion and site demarcation: Were proper road closures, traffic diversions and safety umbrellas in place while heavy work occurred above a live carriageway? Mayor Ritu Tawde publicly questioned this point.
  • Supervision and contractor competence: Did the contractor follow MMRDA’s safety plans and were safety officers on site? Past incidents across India have resulted in fines and accountability actions when contractors failed to implement mandatory safeguards.
Investigators will also examine the chain of approvals — who signed off for the parapet fitment and whether a formal method statement for the operation had been approved and communicated to traffic police and civic authorities.

Patterns, precedents and what the record shows​

This Mulund collapse is not an isolated phenomenon. Over the past several years, India has seen multiple metro construction incidents — from fallen beams and reinforcement cages to pillar collapses — that have resulted in fatalities, serious injuries, project stoppages and punitive actions. Examples include a 2025 Chembur incident where a concrete element fell near residential premises (no fatalities reported), the 2025 Chennai Metro site collapse that led to fines and project review, and other high‑profile pier failures in Bengaluru that provoked criminal inquiries and compensation orders. Safety audits and third‑party checks have become more frequent after such events. These precedents suggest regulators and clients now possess a well‑worn check‑list of likely failures and remedies, but systemic pressure to meet deadlines and budgets continues to create risk.
Academic and industry studies repeatedly show collapse incidents during metro construction cluster around temporary works failures, poor supervision, inadequate inspection regimes and rushed operations — exactly the pressures that accompany accelerated urban infrastructure programs. Learning from pattern analysis is essential, but enforcement and cultural change on site remain the biggest operational hurdles.

Accountability, compensation and legal consequences to expect​

Immediate administrative actions commonly include:
  • a site closure or partial cessation of similar activities until safety checks are completed;
  • an MMRDA‑led technical inquiry (often with third‑party experts);
  • coordination with the municipal police for FIRs if negligence is suspected under criminal statutes;
  • interim relief and compensation announcements by state leadership for families of deceased/injured; and
  • notices and potential penalties to the contractor if contractual or statutory safety obligations are found breached.
In prior cases, metro clients and authorities have levied fines and suspended contractors pending probe outcomes. But long‑term accountability — meaningful remedial action, systemic process change and criminal adjudication where warranted — has varied. A robust, independent and transparent inquiry will be necessary to restore public trust and prevent repetition.

Immediate lessons for commuters and urban managers​

While inquiries proceed, there are practical steps civic authorities and project teams should adopt immediately on any active elevated corridor that runs above busy roads:
  • suspend heavy prefabrication or hoisting operations over live traffic unless a traffic exclusion plan is formally in force and traffic is physically diverted;
  • implement protective canopies or temporary shielding over traffic during any overhead concrete work;
  • require third‑party verification of temporary works for all lifts above public highways;
  • ensure real‑time coordination with traffic police, BMC ward teams and local stakeholders when work is staged near commercial or industrial facilities; and
  • publish transparent daily method statements for heavy lifts and make these available to local representatives to reduce the information asymmetry that fuels public alarm.
These are practical, proven mitigations that can be mandated within days and weeks rather than months. Mayor Ritu Tawde’s public demand — that traffic movement below should have been stopped — aligns with these operational best practices.

Longer‑term reforms the MMRDA and city must consider​

Mumbai’s growth demands an extensive metro grid, but scale cannot come at the cost of basic site safety. The Mulund incident should trigger a systemic reassessment along several dimensions:
  • Independent temporary‑works approval: mandate certified independent design checks and third‑party sign‑off for all temporary works used in heavy lifts over public roadways.
  • Safety‑critical red teams: create an independent safety verification cell within MMRDA that can suspend operations at first sight of protocol lapses.
  • Public exclusion and compensation protocols: adopt mandatory traffic exclusion thresholds based on weight and height of lifts; if traffic cannot be excluded, suspend the lift. Also publish a faster, no‑questions interim compensation mechanism for families impacted by construction accidents.
  • Transparency and community liaison: require pre‑work notices to local representatives and businesses, with a mechanism for immediate escalation and verification.
  • Enhanced contractor pre‑qualification: factor historical safety performance into contractor selection, making safety records a weighted criterion rather than a pass/fail checkbox.
These reforms would increase up‑front cost and schedule margin but reduce catastrophic social and reputational risk, and — crucially — save lives.

What investigators will need to publish to restore public confidence​

Public trust depends less on statements of regret and more on concrete disclosure. Investigations should publish, in a timely manner:
  • the method statement for the parapet installation and the lifting plan used;
  • the certification and inspection logs for the parapet element (material tests, curing records, reinforcement layout);
  • the list of personnel and supervisors responsible for approving the lift and the traffic control plan;
  • CCTV and site video of the operation (if available) with forensic frame‑by‑frame analysis; and
  • the independent temporary works design report and the contractor’s equipment certification (crane load charts, sling certifications, operator licences).
Transparency on these items will help determine whether this was a discrete error, procedural lapse, or systemic weakness in project governance.

Conclusion: emergency now, reform next​

The Mulund parapet collapse is a human tragedy and a wake‑up call. Mumbai’s metro network is a lifeline for millions — and its construction corridors cut through densely occupied urban space where a single failure can cause death, injury and widespread public alarm. The immediate focus must remain on care for the injured, forensic investigation and site safety. But longer term, the episode must catalyse meaningful change: stronger temporary‑works oversight, tighter traffic exclusion rules during heavy lifts, transparent accountability and an enforcement regime that makes safety an executable constraint rather than an aspirational note in tender documents. Without these changes, Mumbai risks repeated incidents that will cost lives and undermine the very public value the metro is designed to deliver.

Recommendations for short‑term action (operational checklist)
  • Halt all similar parapet fitting operations above live traffic on Line 4 pending an independent safety audit.
  • Publish the day‑by‑day method statements for all heavy lifts and notify traffic authorities 48 hours in advance.
  • Institute mandatory protective canopies for active work zones above public roads.
  • Launch an independent forensic team (external structural engineers, temporary‑works specialists) with a public remit and a 7‑day preliminary report deadline.
  • Provide immediate interim financial support to the families of victims and expedited compensation to those hospitalised.
These steps are low‑hanging fruit and essential to protect Mumbai’s citizens while the long‑term investigations and reforms proceed.
The full truth about why the Mulund slab fell will emerge only after careful engineering forensics. In the meantime, the collapsed parapet should force a pause — not only on Line 4 — but on how the city manages the interface between massive infrastructure ambitions and everyday public safety.

Source: ET Now Part of Mumbai Metro Rail pillar collapses in Mulund: 1 dead, 3-4 feared injured — Latest Updates


A concrete parapet segment from an under‑construction Mumbai Metro viaduct collapsed onto LBS Road in Mulund shortly after noon on Saturday, killing one person and injuring several others, and triggering immediate rescue operations, a high‑level inquiry and renewed questions about construction safety on one of the city’s busiest corridors.

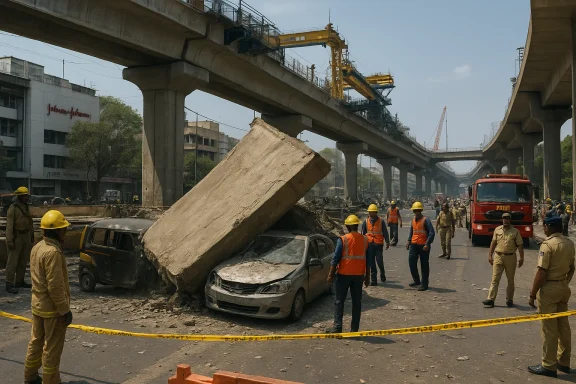

Construction workers inspect a toppled concrete slab crushing a car beneath an elevated highway.Background / Overview​

Mumbai’s Metro Line‑4 — a major elevated corridor intended to link Wadala in central Mumbai with Gaimukh in Thane — runs for more than 30 kilometres across heavily trafficked arterial roads, including long stretches over LBS Road. The project has relied extensively on precast concrete elements, U‑girders and parapet segments lifted and installed by heavy cranes and launching girders in live urban environments. Work on the corridor has required staged night operations, lane closures and frequent traffic management, but also places construction activity immediately above busy vehicular and pedestrian flows.
On Saturday, a parapet slab or parapet segment reportedly came away from the structure near Pier 196, in front of the Johnson & Johnson factory and close to the Mulund Fire Station, and fell onto an autorickshaw and a car traversing the stretch beneath. Local emergency services, the Mumbai Fire Brigade, police, municipal ward teams and the Metro project crew responded rapidly. The Metro authority announced a probe and said the project team was coordinating relief and securing the site. City officials later said the slab measured roughly four by six feet, and named the deceased and other injured persons who were taken to nearby hospitals.
The exact cause of the slab failure is under investigation; officials have already formed a high‑level committee to examine the sequence of events, technical causes and safety compliance. Mumbai civic leaders and opposition politicians responded to the incident by demanding accountability and pointing to long‑standing complaints about site housekeeping, barricading and dust control along stretches of Line‑4 construction.

The incident: what is publicly known​

Timeline and immediate effects​

  • The collapse occurred around midday (reports cluster around 12:15–12:20 PM local time).
  • A concrete parapet segment detached and fell straight onto a moving autorickshaw and partially onto a nearby car.
  • Emergency services reached the location quickly; the autorickshaw driver and passengers were trapped beneath the debris and were extricated and moved to hospital.
  • Officials later confirmed one fatality and multiple injured — with at least one person in critical condition in an intensive care unit.

Victims and official actions​

Authorities identified the deceased and the injured by name in initial briefings to the press, and the local Metro authority said it would bear immediate medical expenses and constituted an investigative committee headed by a senior Metro director to establish facts and responsibilities. Municipal disaster‑management teams cordoned the area and traffic was diverted temporarily while rescue and investigative work proceeded.

What authorities have said publicly​

City and Metro officials have characterised the incident as an accident under investigation. The Mumbai Metropolitan Region Development Authority (MMRDA) said the Metro project team was on site to support relief operations and that a formal inquiry would ascertain the exact cause. Local political leaders called the collapse “huge negligence” and asked whether safety norms were followed — especially given claims that the parapet body had been installed very recently.

Technical context: how these segments are built and where failures can occur​

Metro viaducts in dense urban corridors are typically assembled from heavy precast or cast‑in‑place elements: U‑girders, deck slabs, parapet walls and parapet segments that form the side barriers of the elevated deck. The work often proceeds in short segments, with heavy lifting equipment placing pre‑manufactured components onto temporary supports or launching girders.
Key structural and procedural controls during installation include:
  • Proper anchorage and bearing surfaces for precast elements.
  • Adequate temporary supports and staging during placement and curing.
  • Torque‑checked mechanical fixings, grout for bedding areas, and cured concrete connections.
  • Clear exclusion zones and traffic stoppage under active lifting or finishing operations.
  • Continuous quality control — including nondestructive testing, visual inspection and engineering sign‑offs — before leaving the deck open to traffic.
A failure of a parapet slab can happen for multiple reasons: poor anchorage, incomplete or defective connections to the supporting girder, premature removal of temporary supports, impact or vibration during installation, material defects (voids, honeycombing), or improper handling. Environmental conditions — heavy rain, vibrations from traffic, or nearby excavation undermining bearing soils — can aggravate latent weaknesses.
At this stage, investigators will need to determine whether the segment had been freshly installed, whether all specified connections and grouts had cured, whether any temporary supports or formwork had been removed prematurely, and whether the site’s safety exclusion zones were enforced at the time.

Accountability and regulatory framework​

Construction in Mumbai — especially high‑visibility Metro projects — is governed by a web of contractual obligations, municipal codes and national safety rules for building sites. Project contract documents for MMRDA projects codify a detailed Safety, Health & Environment (SHE) regime that includes mandatory incident reporting, requirements for first‑aid and ambulance tie‑ups, specific penalties for housekeeping lapses, and explicit obligations to barricade and protect public areas from falling objects.
Key accountability mechanisms that come into play after an incident like this are:
  • Immediate emergency response and medical support for victims (often borne by the project authority initially).
  • Formation of an expert inquiry committee to determine technical cause and to recommend remedial and disciplinary action.
  • Enforcement action and recovery of costs or penalties from contractors where negligence or contractual non‑compliance is established.
  • Criminal or civil investigations if evidence points to gross negligence, wilful breaches of safety law, or violations of statutory building codes.
Publicly available project documents and prior tender conditions indicate that MMRDA retains the right to recover damage costs and to levy fines for safety violations. In practice, the speed and transparency of an investigation — and whether independent third‑party forensic engineers are appointed — will determine how credibly responsibility is assigned.

What the city’s recent history and complaints tell us​

The Mulund stretch of LBS Road has been under long‑term construction pressure. Local elected representatives and civic reports in recent months had already raised concerns about dust and debris, broken footpaths, scattered materials and a lack of consistent barricading on the Line‑4 corridor. Those complaints matter because they reflect systemic site‑management issues that can compound into accidents during operations that require precision and controlled exclusion zones.
Historical precedent matters: large infrastructure programmes invariably face accidents during construction. Past incidents on Mumbai metro projects and other urban viaduct constructions have produced similar cycles — accident, inquiry, remedial recommendations, slow compliance and renewed public anxiety. The pattern underscores that procedural safeguards are only as good as on‑the‑ground enforcement and contractor discipline.

Technical analysis — plausible failure modes (and what investigators will look for)​

Investigators will combine visual inspection, material testing and forensic structural analysis. The main lines of technical inquiry typically include:
  • Connection integrity: Were anchor bolts, dowels and grout installed and torque‑checked per specification?
  • Curing time and sequencing: Was the parapet element left to cure or was it put into service prematurely?
  • Lifting and handling damage: Did a lifting sling or crane operation damage the element or its contact faces?
  • Material defects: Are there voids, honeycombing, or poor concrete consolidation that reduced strength?
  • Temporary works failure: Did scaffolding, staging or formwork give way, transferring load to an unsupported element?
  • External impacts: Were there recent impacts, collisions or heavy vibrations that compromised the feature?
  • Design mismatch or detailing errors: Was the parapet design or detailing inadequate for the local conditions or the method of construction?
Forensic testing that typically follows includes core sampling of the concrete element, petrographic analysis, scanning for internal voids, metallurgical testing of fasteners, and strain/vibration analysis of the adjacent span.
Important caution: until inspectors complete hands‑on testing and trace the chain of custody of materials and records, technical explanations remain provisional. Any public technical assertion should be framed explicitly as hypothesis pending verification.

Technology that could reduce risk — structural health monitoring, digital twins and AI​

This accident re‑focuses attention on the role of digital technologies in preventing catastrophic failures and in improving construction safety in busy urban projects. Several mature and maturing technologies offer practical mitigations for the specific class of risk illustrated here:
  • Structural Health Monitoring (SHM) sensor networks
  • Small, rugged accelerometers, strain gauges and inclinometers can continuously monitor vibration, tilt and strain on critical spans. Continuous baselines allow rapid anomaly detection after an unusual event or gradual deterioration before a collapse becomes imminent.
  • Wireless, low‑power sensor nodes that forward data to an on‑site gateway make retrofitting practical and affordable across many spans.
  • Digital twins and BIM integration
  • Combining a geometric Building Information Model (BIM) with real‑time sensor feeds creates a digital twin that maps sensor data to location and element. This lets engineers visualise stress hotspots and historical trends in context.
  • Digital twins also allow simulation of temporary works sequences during erection — predicting how loads flow through incomplete structures and identifying risky sequences before they are executed.
  • Edge computing and machine learning
  • Edge devices can perform high‑frequency signal processing to detect abnormal vibration signatures and to generate immediate, low‑latency alerts even if cloud connectivity is temporarily unavailable.
  • Machine learning models trained on normal service‑load vibrations can flag spectral anomalies that often precede failures.
  • Drones, thermal LiDAR and high‑resolution inspection
  • Unmanned aerial vehicles fitted with LiDAR, high‑resolution cameras and thermal imaging can rapidly inspect inaccessible surfaces and detect cracks, delamination and thermal anomalies that are not visible from street level.
  • Computer vision for process compliance
  • Cameras and AI can monitor whether exclusion zones are enforced under active lifting operations, whether workers wear PPE, and whether temporary support systems are in place during operations involving heavy elements.
Why these matter: peer‑reviewed case studies and pilot projects show that affordable SHM networks combined with digital twins and ML analytics can detect irregularities long before visible distress occurs, and can be scaled across many spans at cost levels that compare favourably with the human and reputational costs of a single major accident.

Practical deployment blueprint (how an urban metro project could roll this out)​

  • Baseline survey and risk prioritisation
  • Identify the highest‑risk spans and launch points (busy roads under viaducts, newly installed sections, known problematic details).
  • Instrumentation
  • Fit accelerometers, strain gauges and tilt sensors on target spans and parapet elements.
  • Use fibre‑optic or vibrating‑wire strain gauges for long‑term, high‑precision monitoring on critical connections.
  • Edge + Cloud architecture
  • Use local gateways for real‑time preprocessing and alerting; forward time‑series data to a central cloud for longer‑term analytics and model training.
  • Digital twin mapping
  • Link sensors to the BIM geometry so alerts identify exact element, joint or pier location.
  • Operational integration
  • Integrate alerts with on‑site control rooms, traffic management centres and emergency services.
  • Require a formal “go/no‑go” safety clearance generated by the digital system before re‑opening traffic under recently completed works.
  • Governance and audit
  • Make sensor data auditable and part of contractual acceptance criteria for precast element installation and turn‑over to operations teams.
These steps are practical and increasingly supported by off‑the‑shelf instrumentation, standards‑compliant data platforms and tested workflows that reduce false alarms while providing credible, time‑stamped evidence about site conditions.

Organizational and contractual remedies​

Technology alone does not prevent accidents. Equally critical are organizational and contractual changes:
  • Enforceable stop‑work rules with independent safety officers who can halt operations if exclusion zones are violated.
  • Third‑party independent safety audits at predetermined milestones and after complex lifts.
  • Mandatory pre‑installation testing and certification for precast elements, including traceable material test certificates and lifting gear logs.
  • Clear allocation of liability and recovery mechanisms in contracts, along with fast compensation protocols for victims.
  • Transparent public reporting of incidents and corrective actions to rebuild trust in major public works.
On the contractual side, project authorities should embed data‑driven acceptance criteria: an installed parapet segment should only be cleared for live traffic when sensor and inspection evidence confirm all performance indicators and curing/connection checks are within tolerance.

Political, social and legal implications​

A collapse on a busy arterial road in a megacity has immediate political resonance. Public confidence in large infrastructure programs rests on visible safety performance. When accidents occur, they:
  • Trigger political scrutiny and demands for resignations or contract cancellations.
  • Expose municipal and project governance failures that opponents and media amplify.
  • Delay project timelines as investigations and corrective measures interrupt work and require re‑inspection of similar elements across the corridor.
  • Create a legal cascade (criminal negligence inquiries, civil suits, worker compensation claims) if investigations find procedural lapses.
For authorities, the balance between fast delivery and rigorous safety compliance is under intensifying public scrutiny. The long‑term reputational and financial costs of accelerating schedules without commensurate investment in quality assurance and digital monitoring are demonstrably large.

What the public should expect from an investigation​

Good practice in such investigations includes:
  • Rapid on‑site forensic documentation and preservation of evidence (photographs, lifting records, material certificates).
  • Independent third‑party structural engineers conducting neutral analyses.
  • Clear public statements that avoid premature technical conclusions; instead, provide timelines and interim findings.
  • Immediate remedial actions for comparable spans (temporary closures, inspections, preventive stabilization) while the probe continues.
The investigation must answer these concrete questions: Was the element properly designed and manufactured? Was it installed according to the sequence and with all temporary supports? Were testing and curing protocols followed? Were safety exclusion zones enforced and traffic halted during unsafe operations?

Strengths in the current response—and the gaps​

Strengths:
  • Emergency services and project teams reached the scene quickly and carried out rescue operations.
  • Authorities rapidly constituted a high‑level committee and committed to bearing medical expenses for the injured.
  • The incident has prompted immediate political and civic discussion — necessary for accountability.
Gaps and risks:
  • Early reports indicate the parapet segment may have been fitted very recently; if true, this raises questions about whether final sign‑offs and curing periods were respected.
  • Multiple prior local complaints about housekeeping and barricading suggest systemic site‑management weaknesses that a single inquiry needs to address comprehensively.
  • Without rapid, transparent release of technical evidence and independent expert validation, public trust will naturally erode and similar stretches of the corridor will remain subject to fear and delay.

Lessons for other cities building fast urban transit​

  • Treat temporary works and staging as first‑class design elements. Temporary supports and lifting sequences should be engineered, documented and inspected with the same rigor as permanent design.
  • Instrument high‑risk locations proactively. A modest network of sensors can provide decisive early warning and legally defensible records.
  • Integrate digital twins into project governance as a compliance tool, not just a design convenience.
  • Make data auditable. Sensor logs, inspection photos and sign‑offs need to be tamper‑proof and accessible to independent auditors.
  • Communicate clearly and promptly to the public. Transparent interim updates reduce speculation and restore procedural trust.

Conclusion​

The Mulund collapse is a stark reminder that even well‑funded, strategically vital infrastructure projects remain vulnerable to failures when on‑site discipline, temporary works planning and real‑time monitoring are inadequate. The human cost — a life lost and multiple injuries — is the most urgent reality. For city managers and engineers, the incident exposes a set of avoidable risks: rushed sequences, poor housekeeping, inadequate barricading and reliance on manual inspection regimes that cannot scale.
Mitigation is possible, and increasingly affordable: an integrated approach that pairs structural health monitoring, digital twins, disciplined contractual enforcement and empowered, independent safety oversight would materially reduce the probability of similar tragedies. The MMRDA’s inquiry will have to be rigorous, transparent and swift; its recommendations should mandate technological and contractual reforms so that the city’s residents can safely share the space under the very infrastructure being built to serve them.

Source: ET Now Part of Mumbai Metro Rail pillar collapses in Mulund; 3-4 feared injured - Latest Updates


Content Advisory 43%
This content contains violent themes or language that may be disturbing to some readers.
Primary concern: Violent Content
While serious topic discussion is allowed, graphic violence may be distressing to community members.
AI Content Assessment · Feb 14, 2026
Back
Top
